Data centres in Western Sydney want up to 28 gigawatts of power. The grid expects just 3.67 gigawatts by 2036. That gap now defines the sector.

The Business Desk is a contributing writer covering business and public affairs for The Sydney Times.

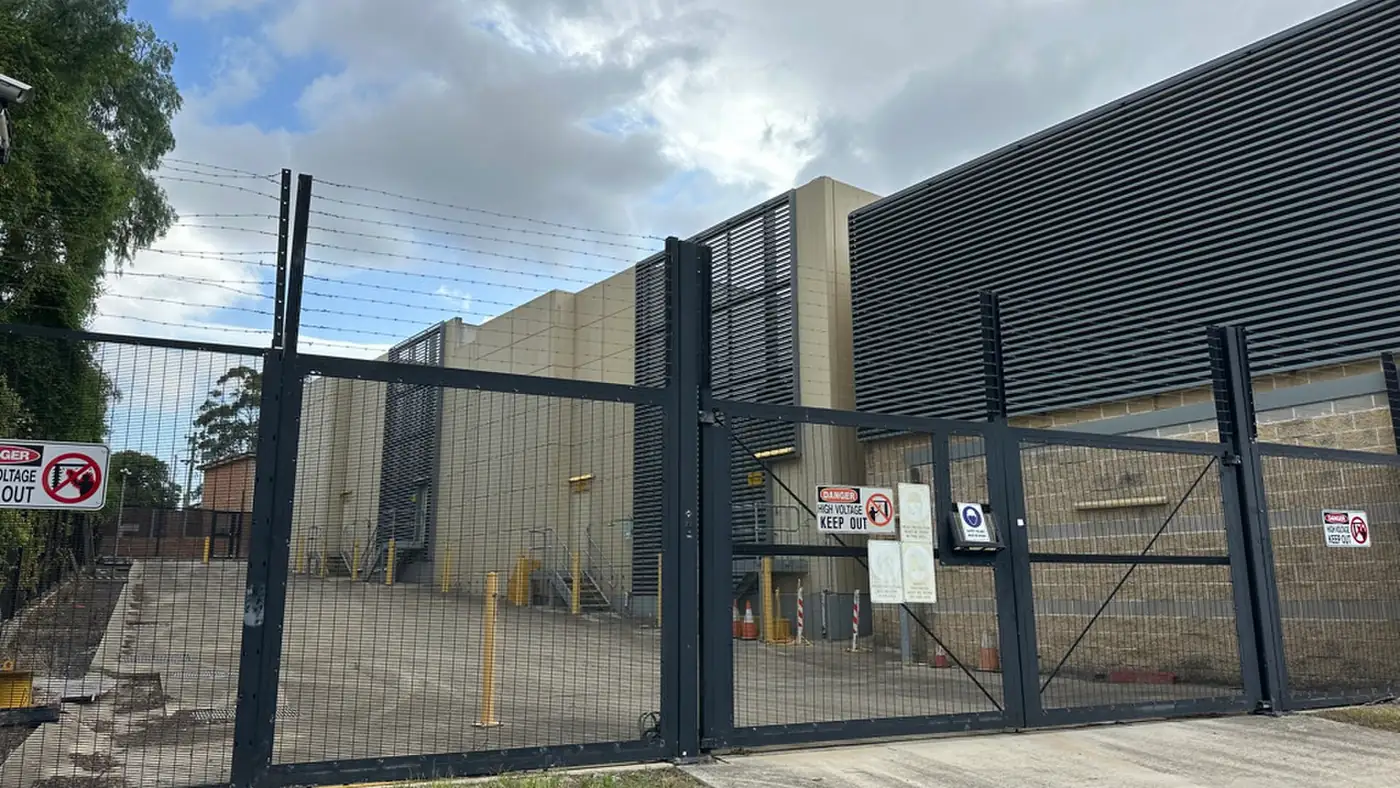

The Sydney data centre grid connection queue is now the binding constraint on the sector's growth. Energy Networks NSW has a pipeline of up to 28 gigawatts of proposed data centre load in its distribution zone alone, and the network operator serving that zone says it can offer no further connection capacity for large loads beyond 2033. On its own forecast, Baringa, the proposed substation that would serve Blacktown and the Penrith growth corridor, grows from 660 megawatts by 2027 to 3.67 gigawatts by 2036. Most of that growth is hyperscale compute.
The gap between 28 gigawatts of ambition and 3.67 gigawatts of forecast delivery is not a modelling artefact. It is the reason boardrooms in Sydney are now discussing grid connection timelines more carefully than land supply.
AEMO's 2026 Electricity Statement of Outlook models NSW data centre electricity consumption rising from roughly 4.2 terawatt hours to about 34 terawatt hours by 2036. That forecast was carried directly into the final Integrated System Plan, the first edition in which data centres are treated as a distinct driver rather than a general load growth line item.
The project pipeline is larger than the forecast. AEMO identifies 225 proposed connection projects across the NEM, of which 165 are already operating and 60 are in construction or committed, with a combined indicative cost of $51.4 billion. NSW accounts for two thirds of the pipeline capacity. The later Integrated System Plan scenarios push the national figure considerably higher, and the trajectory in the final ISP is steeper than the outlook that informed it.
The point to hold onto is that the forecast is a modelling output, not a queue. Developers apply for connections; AEMO publishes scenarios; planners decide what to build. Treating the 34 terawatt hour number as a schedule produces bad investment decisions.
The NSW Government established a Data Centre Taskforce in September 2025, chaired by the Energy Minister, to develop a sector-specific regulatory framework. That work has been overtaken by events. The Electricity Infrastructure Investment Amendment Bill 2026, passed in December 2025, established a new regulatory category for "high impact infrastructure" that allows the Minister to declare future projects critical without waiting for them to enter the official Integrated System Plan.
The Bill is now before the Legislative Council, which amended it in September 2026 to remove provisions permitting retrospective declarations, require the independent grid operator to procure from the competitive market, and mandate public consultation on any proposed declaration with at least 60 days notice. A further amendment would create an offence of misleading the regulator or Minister.
The unresolved question is the threshold. A low bar brings projects forward faster at the cost of public confidence in the process. A high bar leaves the 28 gigawatt pipeline with nowhere to go. The Essential Services Commission has been directed to develop accreditation standards for new market entrants, a drafting task that will effectively define who is allowed to build inside the critical designation.
Regional NSW carries the load, which means the data centre debate is a regional development debate. Blacktown's development panel has had to advise on proposals for buildings over 60 metres, directing questions to the Department of Planning rather than resolving them locally. Bathurst's Local Environmental Plan rates its data centre precinct as high impact development. Narrandera has attracted four proposals. The Riverina, the Mid-Coast and the Illawarra are all competing for the same connection studies and the same specialist construction labour.
This is why the 2026-27 NSW Budget's $3.8 billion for Western Sydney hospitals and $3.5 billion for roads is not disconnected from the data centre pipeline. Both are competing claims on the same construction workforce and the same Western Sydney growth corridor.
Beginners Energy's 2026 report on the Mt Thorley Wodonga connection sets out the pricing mechanics precisely. Total costs are split between connection assets that the applicant funds, dedicated assets, and an "enabling" share of the wider network that existing customers fund. The NSW Distribution Determination for 2026-2030 applies a materiality threshold above which a single new large load must contribute to network augmentation, with an accelerated contribution for loads above the upper threshold.
A load sits at the lower end of that range and pays almost nothing. A load near the upper end pays a share so large that the project's business case turns on either contracted future revenue or on the developer's ability to pass the cost through. When the enabling share is reassessed in the next determination cycle, a project that was economic last cycle can stop being economic.
AEMO and the Reliability Panel noted this sequencing risk directly in the 2026 assessment: a connection agreement signed on today's rules is not a guarantee of supply under the next determination period.
Three things follow. First, connection queue position is now a tradable asset, and developers with early-stage sites in the Inner West and Eastern Suburbs face a genuine decision about whether to pursue expedited greenfield connections outside the established footprint. Second, co-locating compute with generation is moving from an exotic proposition to a commercial requirement, and hybrid arrangements in Western Sydney are no longer pilots. Third, the accreditation standards the independent regulator is developing will determine whether the pipeline converts to steel or stays a slide deck.
For readers tracking this space, the AEMO Electricity Statement of Outlook and the Essential Services Commission of NSW consultation papers are the two primary sources worth watching. Our Business and Markets desk covers the commercial side, and Tech & Ideas follows the AI infrastructure build-out. Industry context sits with the Australian Energy Market Operator.
