Western Sydney Airport is preparing for its first full year of operations.
The new master plan lifts Sydney Olympic Park capacity to 2.28 million square metres and charges developers $241 per square metre for infrastructure.

The City Desk is a contributing writer covering city and public affairs for The Sydney Times.

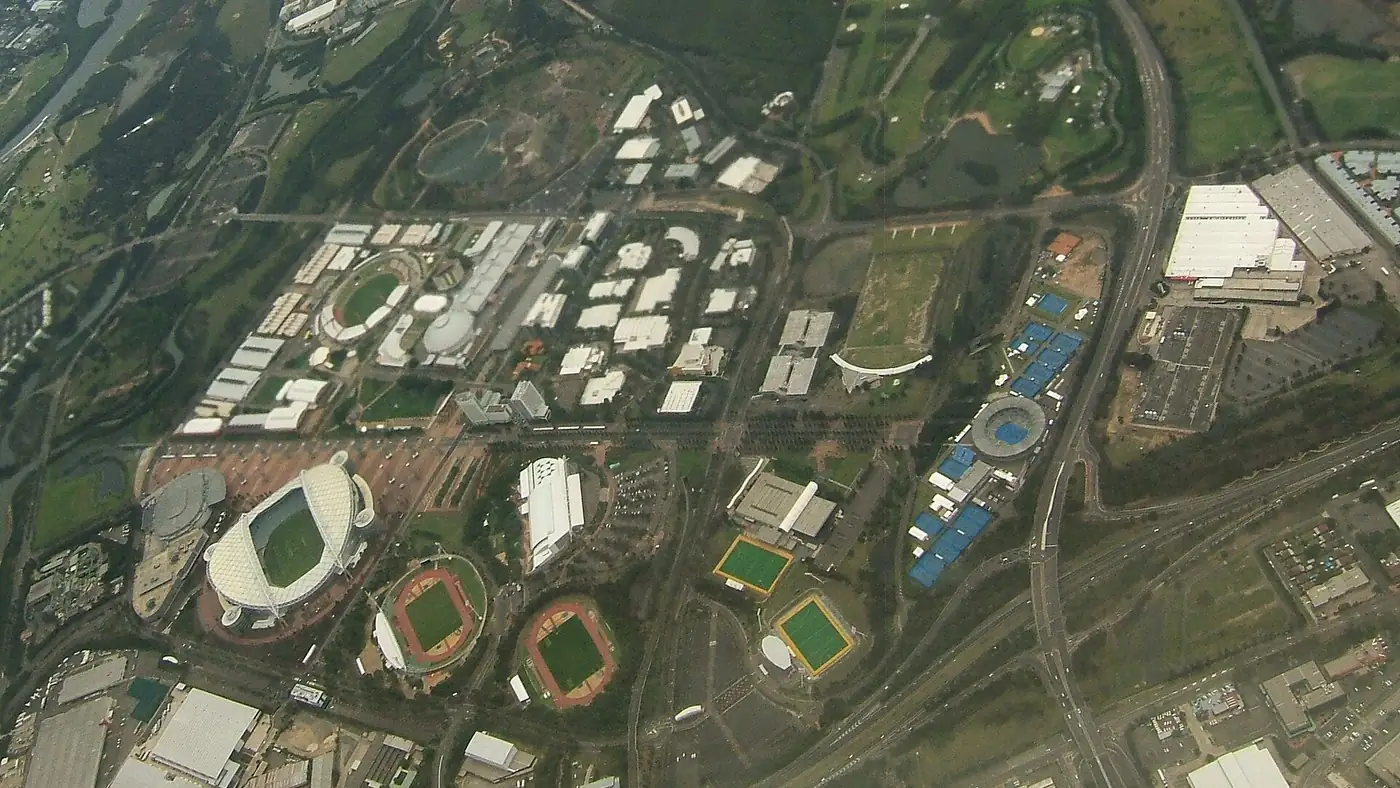

The Minister for Planning and Public Spaces approved the Sydney Olympic Park Master Plan 2050 on 1 April 2026, replacing the previous plan and lifting the precinct's maximum development potential to 2.28 million square metres of gross floor area. The plan supports up to 26,000 jobs and 15,000 homes, and adds 2,000 homes to what was previously planned.
The same approval cycle introduced a charge on developers that functions as an admission of an infrastructure shortfall. The Local Infrastructure Contributions Framework 2026 sets a contribution rate of $241 per square metre, derived from an estimated infrastructure cost of $439,019,600 divided across the net increase in floor space of 1,824,363 square metres.
The precinct totals 640 hectares, of which the Sydney Olympic Park Authority manages 220 hectares of urban core and 430 hectares of parklands. The maximum development potential is 2,282,662 square metres, of which 458,300 square metres already exists, giving a net increase of 1,824,363 square metres.
Projected population is up to 33,000 residents. The plan publicly exhibited its draft stage drew 476 formal submissions alongside 426 direct conversations at information sessions.
Seven sporting venues sit under authority management, covering aquatic, indoor, archery, hockey, athletics and warm-up facilities. Venues hosted over 1,000 events and a record 12 million visitors in 2024-25.
Chief executive Neisha D'Souza, who started in January 2025, framed the plan as "the catalyst for investment and growth," bringing "certainty and unlocking opportunity" while retaining what the precinct already has. The authority manages more than $2.5 billion of significant community assets.
The $241 per square metre figure is indexed quarterly against the ABS producer price index for road and bridge construction in NSW, and includes a 1.5 per cent administration allowance benchmarked to IPART.
An infrastructure contributions framework at this scale is not an administrative novelty. It is the mechanism by which an authority that has been asked to deliver substantially more floor space does not have to fund the resulting infrastructure from its own balance sheet.
SOPA is also establishing a special entertainment precinct in the park, aligned to a 25-year horizon and relying on Sydney Metro West, the Parramatta Light Rail extension and the state and federally funded Homebush Bay Drive roundabout upgrade for transport capacity.
SOPA is constituted under the Sydney Olympic Park Authority Act 2001, and the Minister for Planning and Public Spaces is the consent authority for all development in the park other than exempt development. The board endorsed a Corporate Strategy 2025 to 2032 in April 2025, and reduced the number of asset management plans it operates from 23 to four.
The NSW Budget 2026-27 allocated $17.0 million for planning of the WIN Sports and Entertainment Precinct redevelopment at Penrith, a separate commitment to the park itself.
The plan and the contributions framework sit with the Sydney Olympic Park Authority and NSW Planning's precinct documentation. Our City planning coverage tracks the eastern and western rezonings.
